Last Updated on 18th February 2026 by peppe8o

Project management involves strong communication requirements. Keeping all teams aligned on task progress and issue solutions requires strong tools to share info between involved owners and a strict timeline for sharing.
In this guide, I’ll show you how to install Redmine on your Raspberry PI computer board with Docker.
For this guide, I will use a Raspberry PI 5 model B (8GB), but this also works with all the Raspberry PI computer boards supporting the 64-bit OS.
What is Redmine
Redmine is an open source project management platform, based on a web application service. Written using the Ruby on Rails framework, it is cross-platform and cross-database. It allows for managing multiple projects and associated subprojects, with related objects like tasks, issues, file management and GANTT charts.

What We Need
As usual, I suggest adding from now to your favourite e-commerce shopping cart all the needed hardware, so that at the end you will be able to evaluate overall costs and decide if to continue with the project or remove them from the shopping cart. So, hardware will be only:
- Raspberry PI Computer Board (including proper power supply or using a smartphone micro USB charger with at least 3A)
- high speed micro SD card (at least 16 GB, at least class 10)
Step-by-Step Procedure
We’ll start by installing the Raspberry PI operating system, and then setting up Docker and Docker Compose. After that, we’ll prepare docker-compose configuration files to create our Redmine platform with only 1 command line.
Redmine requires a database and works well with MySQL. I use MariaDB instead of MySQL because it is fully compatible and requires fewer resources (which is a good idea working with low-capacity hardware like Raspberry PI).
Prepare the Operating System
The first step is to install the Raspberry PI OS Lite to get a fast and lightweight operating system (headless). If you need a desktop environment, you can also use the Raspberry PI OS Desktop, in which case you will work from its terminal app. Please find the differences between the 2 OS versions in my Raspberry PI OS Lite vs Desktop article. For low-RAM Raspberry PI models, I suggest setting the Swap Memory of Raspberry PI to a higher value (1028MiB) or more.
In both cases, we need the 64-bit version for the OS.
Please make sure that your Operating System is up to date. From your terminal, use the following command:
sudo apt update -y && sudo apt full-upgrade -y
We also need to install Docker. You can use my tutorial for this: Beginner’s Guide to Install and Use Docker with Raspberry PI.
Prepare the Docker-Compose Configuration File
Create a Redmine folder in your Raspberry PI. I’m going to name it “redmine”, but you can use whatever name you want. Then enter your folder. From terminal:
mkdir redmine
cd redmine
Create the docker-compose file:
nano docker-compose.yml
and add the following code. Use your favourite credentials for “redmine_password” and “redmine_supersecretkey”. On the other hand, the name for the Redmine database must remain unchanged (“redmine”):
# Redmine form peppe8o.com
services:
redmine:
image: redmine
restart: unless-stopped
ports:
- 8080:3000
environment:
REDMINE_DB_MYSQL: db
REDMINE_DB_PASSWORD: redmine_password
SECRET_KEY_BASE: redmine_supersecretkey
volumes:
- ./redmine_files:/usr/src/redmine/files
db:
image: mariadb:latest
restart: unless-stopped
environment:
MYSQL_ROOT_PASSWORD: redmine_password
MYSQL_DATABASE: redmine
volumes:
- ./mysql_data:/var/lib/mysql
Save and exit.
As you can see, our database (“db” service) will be built on the latest MariaDB image. If you have a 32-bit OS, you can optionally change this part with a custom MariaDB installation (please refer to create custom MariaDB container on Raspberry PI for more info).
From the Docker Compose file, we use the restart: unless-stopped policy. This allows our Redmine to automatically restart even after the Raspberry PI reboots, unless you manually stop the container.
The port mapping for the Redmine service allows us to reach the Redmine service from the 8080 port on the Raspberry PI’s IP address instead of using the 3000 (the default Redmine port).
The volumes will enable us to keep the Redmine data persistent over container stops and starts. This Docker Compose script creates the volumes in the same folder where the docker-compose.yml file is saved. This will result in a simpler backup process for you.
Finally, a brief explanation of the 2 passwords: the REDMINE_DB_PASSWORD sets the database password to use with the db service. This must be the same as the one used in the MariaDB container. The SECRET_KEY_BASE encrypts the Rails sessions and cookies.
Service Creation and Initialisation
With the previous file ready, you will be able to install and get Redmine up with the following terminal command:
docker-compose up -d
This process will take a while to download and extract the required images from Docker Hub. Once the container preparation has been completed, from the terminal, you will see something like the following:
[+] up 3/3
✔ Network redmine_default Created
✔ Container redmine-redmine-1 Created
✔ Container redmine-db-1 Created
At this point, you can also check the Redmine logs with the following command:
docker logs redmine-redmine-1
Please wait until the previous log command gives you something like the following:
(...)
* Min threads: 0
* Max threads: 5
* Environment: production
* PID: 1
* Listening on http://0.0.0.0:3000
Get Redmine Default Data
After the installation, Redmine offers you an empty database. You don’t have, for example, the definition of tasks or even their status.
Anyway, you can get a brunch of default settings with the following command:
docker compose exec redmine bundle exec rake redmine:load_default_data RAILS_ENV=production
Access Redmine on Raspberry PI
From your favourite browser, please use your Raspberry PI’s IP and port 8080 as the URL to access your Redmine service. For example, with my Raspberry PI my URL will be http://192.168.1.218:8080:

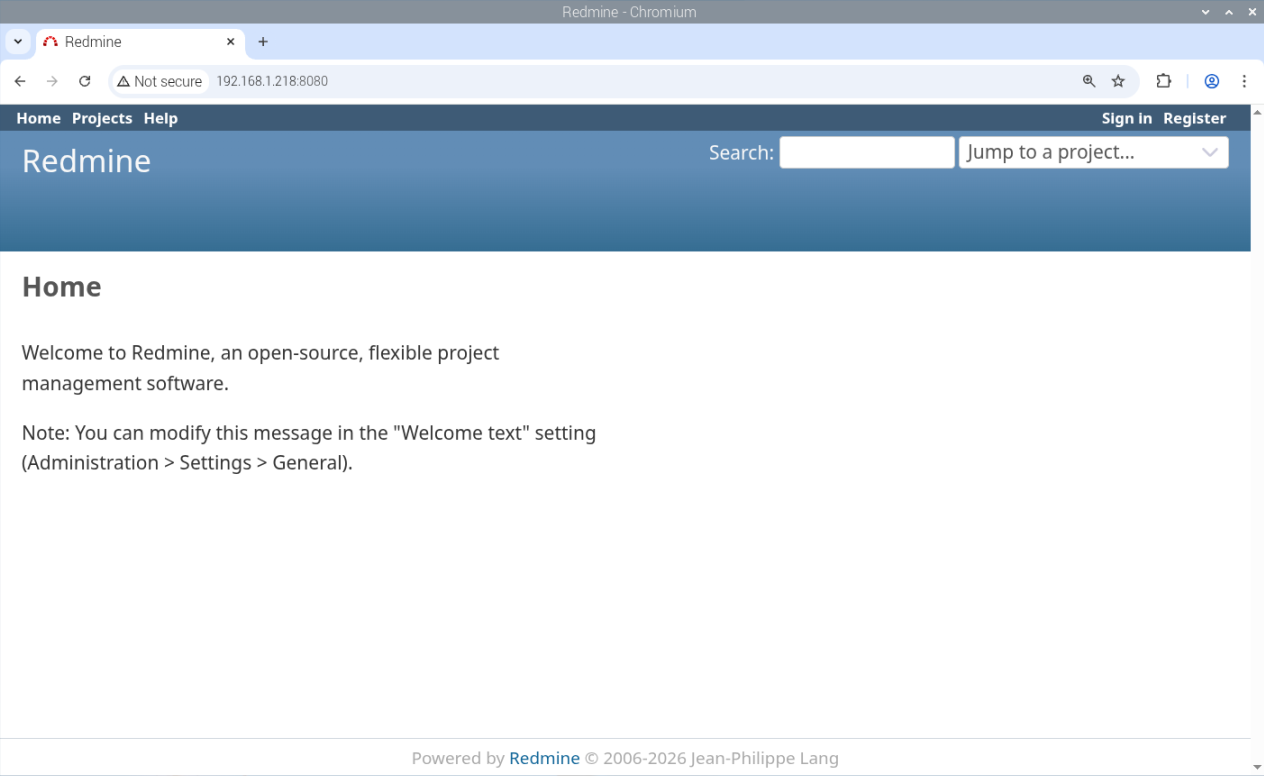

If this is your output, it means that everything went well.

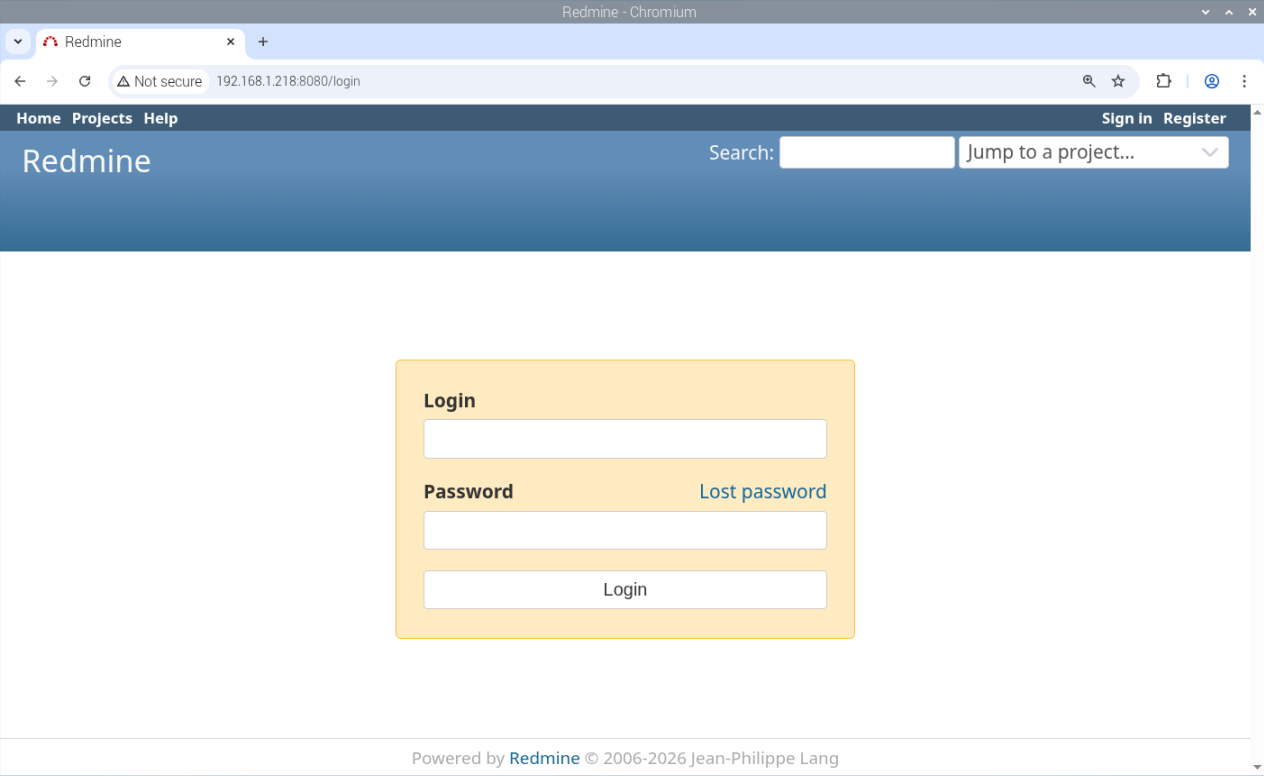

Use the “Sign in” link on the top/right side of the page to reach the signing form:

Use the following default Redmine credentials:
- login: admin
- password: admin
and click login.

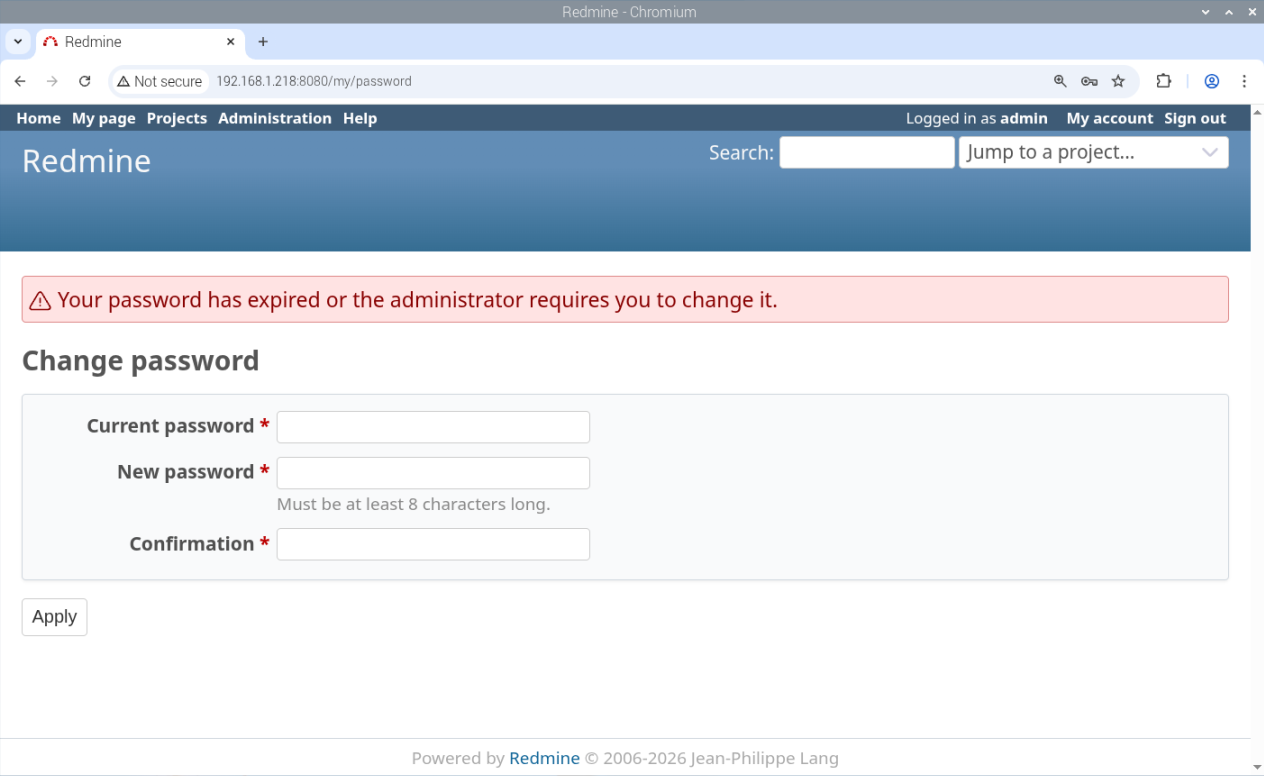

You will be asked to change the admin password. Insert the old “admin” in the password field. Use a new password for the other 2 fields:

Then click the “Apply” button. You will be logged in.

Now, you can customise your installation by changing the account information and clicking SAVE:

Create a Project with Tasks

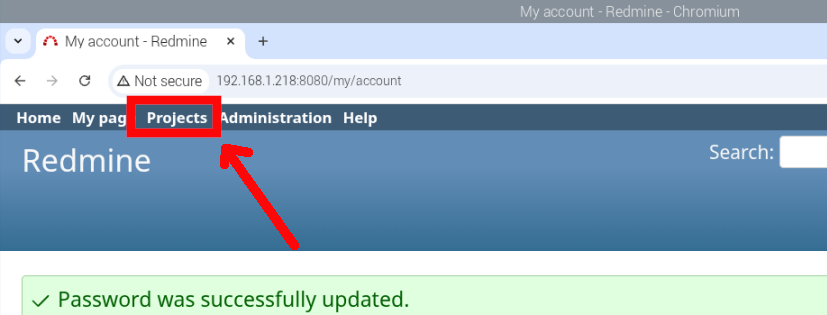

From the previous page, please click the “Projects” link at the top:

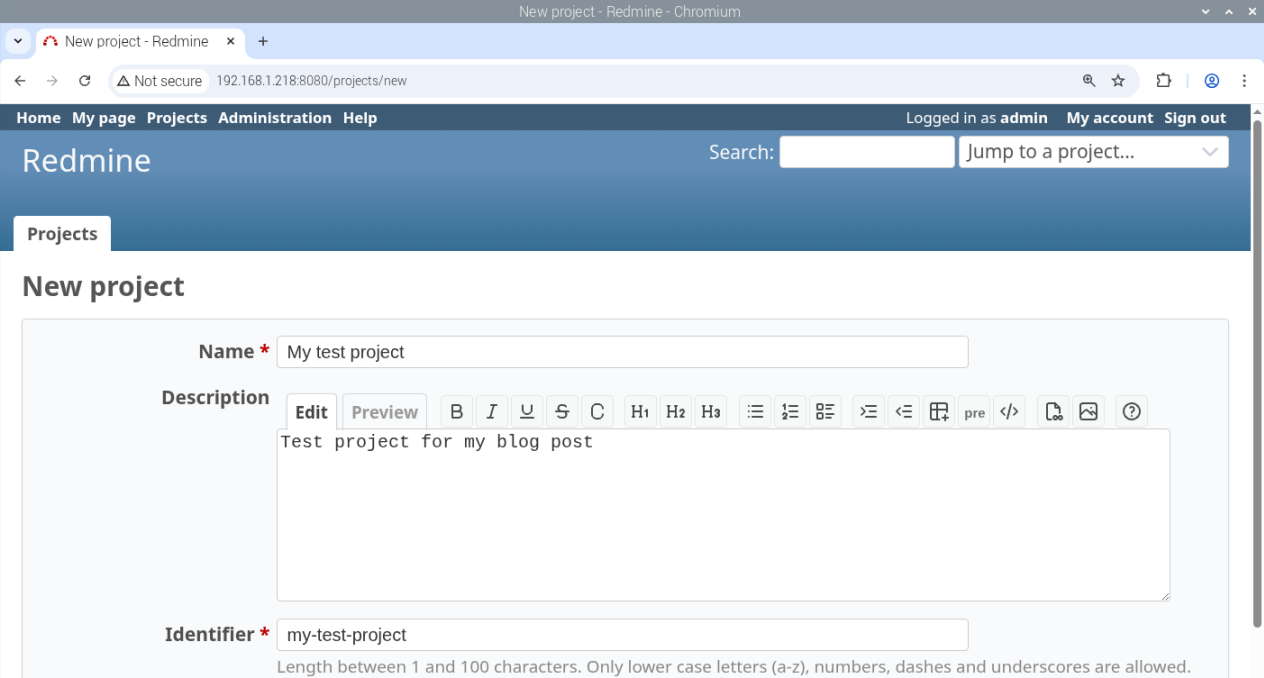

Create a new project by clicking the related link, as shown in the following screenshot:

Please fill in the fields according to your preferences. Those with an “*” are mandatory:

Please check that the Issue Tracking module is enabled:

Scroll down and click the “Create” button at the bottom of the page.

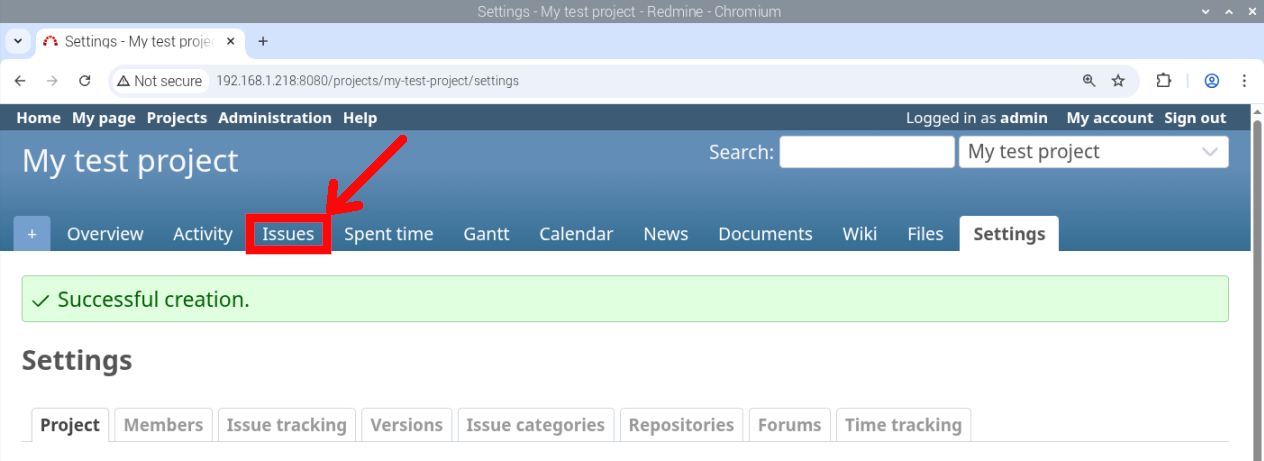

Now, you will find a bar with all the modules for your project. Please select the “Issues” module:

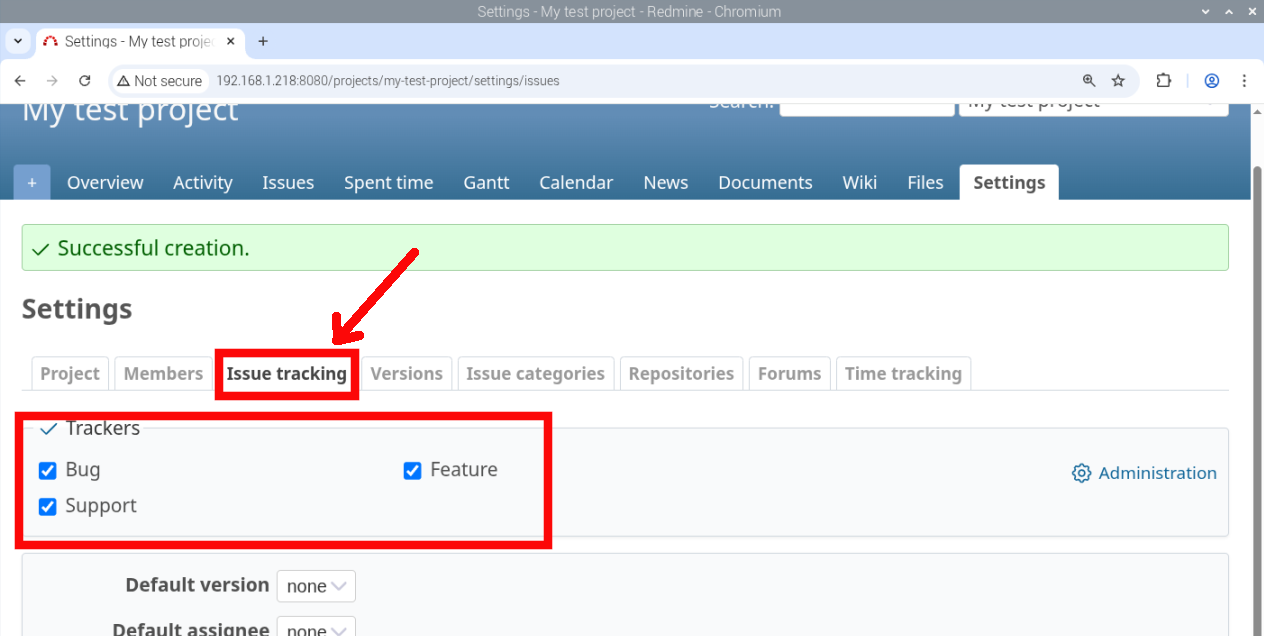

By default, in the “Issue tracking” tab, you should find Bug, Feature, and Support tasks enabled:

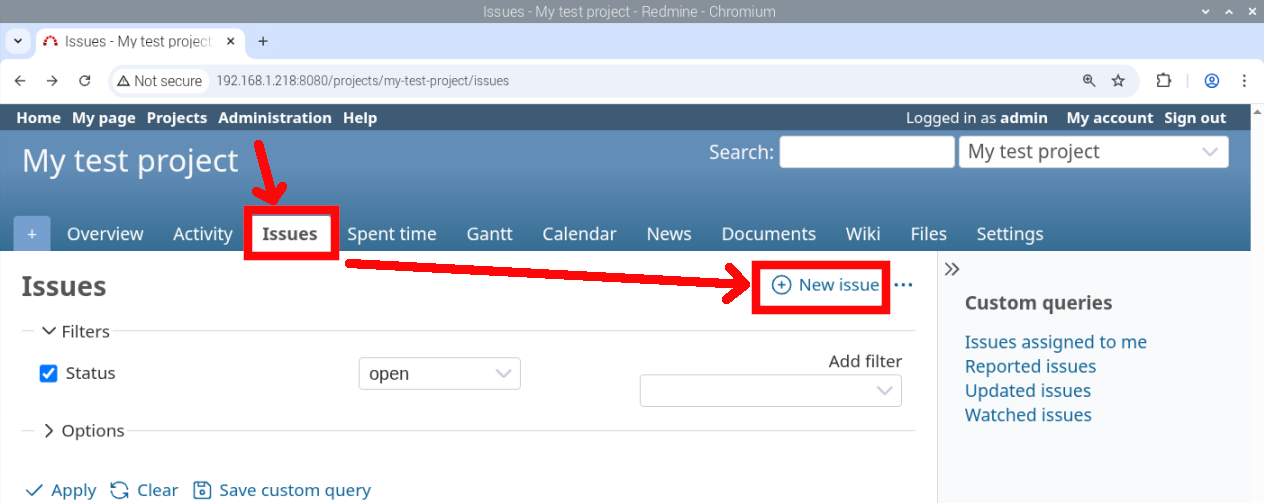

From the project, please go to the “Issues” tab, and click “New issue”:

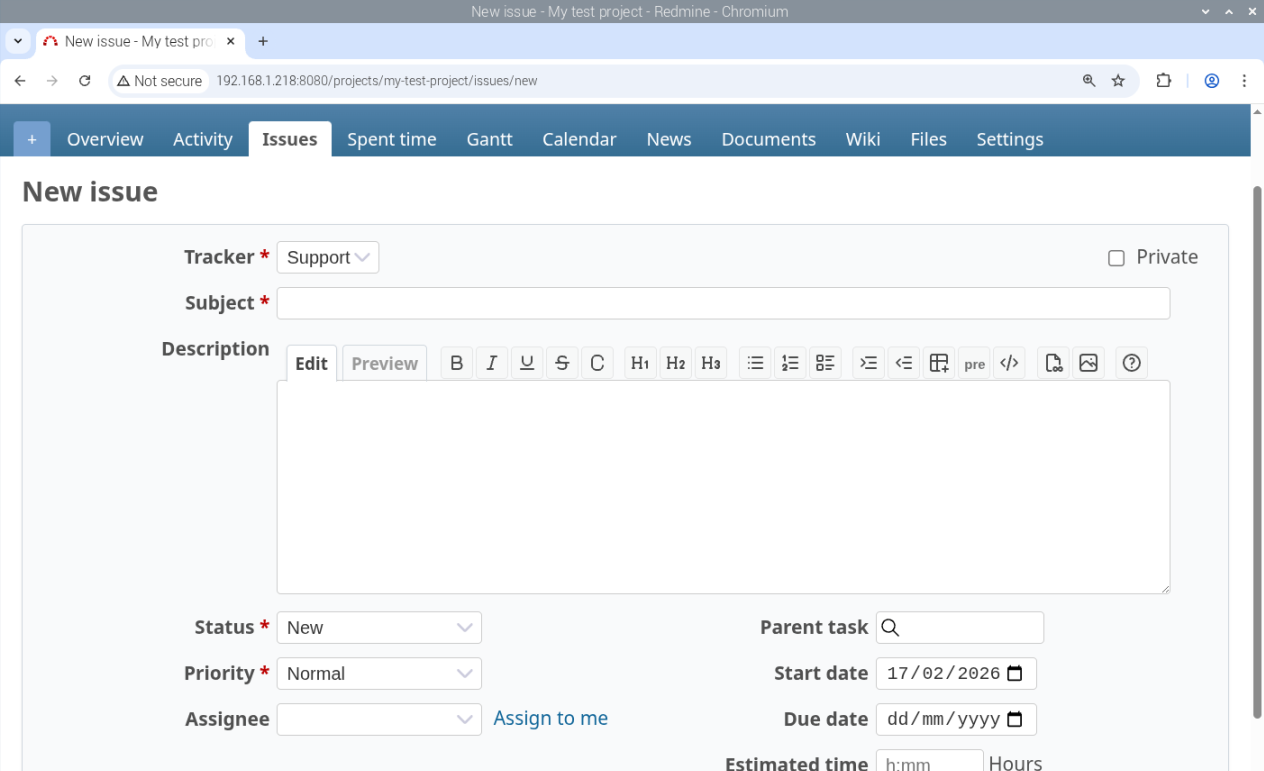

Here you’ll find a form to compile to add as many tasks as you like:

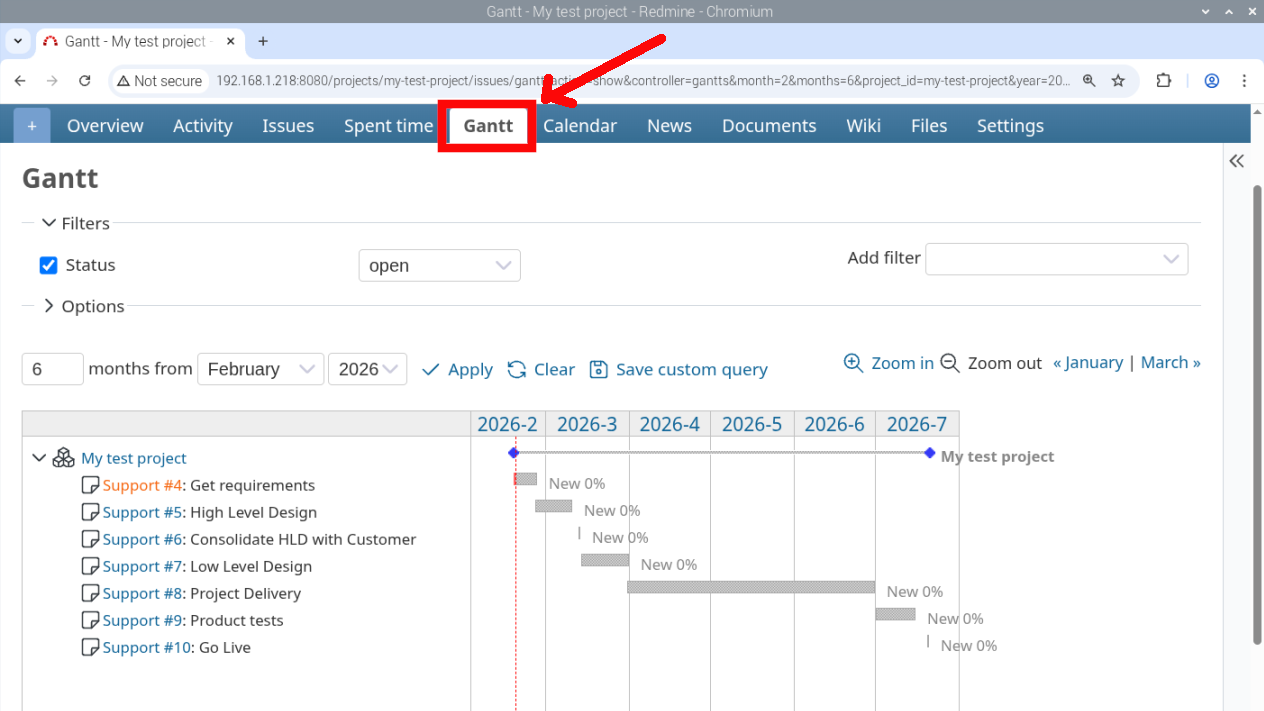

When you finish creating your tasks, you can see them in a GANTT chart:

From here, you can refer to the Redmine Users Guide, and your Redmine platform is ready.
Resources
Next Steps
If you are interested in more Raspberry PI projects, take a look at my Raspberry PI Tutorials or subscribe to my newsletter!
Enjoy!
